Mastering Requirements Test Case Execution in Tricentis Tosca: A Complete Guide

Requirements Test Case Execution

Table of Contents

Introduction

Making sure that testing fully supports and reflects business needs is essential for the success of any software project. Tricentis Tosca provides a powerful framework to connect requirements, test cases, and execution lists ensuring complete traceability from requirement definition to final test results.

For QA professionals pursuing TOSCA Training, mastering Requirements Test Case Execution is not just about knowing the tool; it’s about understanding how Tosca links business intent to test validation. This guide walks you through every step from creating requirements and linking test cases to configuring automatic updates and tracking execution progress all based directly on Tricentis Tosca’s official documentation.

Understanding Requirements Management in Tosca

Requirements management in Tosca is the foundation of structured test planning. It enables users to capture business objectives, convert them into measurable criteria, and ensure that all aspects of software functionality are validated.

Each requirement in Tosca can represent a business goal, functional module, or system specification. Requirements are organized into hierarchical structures called RequirementSets, which can contain multiple individual requirements.

The Requirements Test Case Execution process begins here: each requirement is linked to one or more test cases, ensuring traceability and enabling automatic calculation of coverage and progress.

Key Functions of the Requirements Section

  • Documenting and categorizing all business and functional requirements.
  • Linking requirements with test cases and execution results.
  • Monitoring progress using the “Execution State (%)” metric.

How to Create Requirements in Tosca

Creating requirements in Tosca follows a simple, hierarchical approach. According to Tricentis documentation, you can build an organized structure of folders, sets, and requirements to support easy navigation and reporting.

Step-by-Step: Create Requirement Structures

  1. Navigate to the Requirements section in Tosca Commander.
  2. Right-click the Requirements root node and select Create Folder to organize related items.
  3. Inside the folder, create a RequirementSet.
  4. Select the RequirementSet, then right-click and choose Create Requirement.

Each created requirement can have attributes such as Name, Description, Work State, Execution State, and Weight. These attributes drive accurate reporting in Requirements Test Case Execution.

Tip: Organize for Clarity

  • Use requirement folders to separate modules or project phases.
  • Give meaningful names and descriptions for quick traceability.
  • Update Work State values to reflect progress (Planned, In_Work, or Completed).

Linking Requirements to Test Cases

Once requirements are created, the next essential step in Requirements Test Case Execution is linking them with test cases. This linkage allows Tosca to measure how much of a requirement is covered and how well it performs.

How to Link Requirements to Test Cases

  1. Open both the Requirements and TestCases sections in Tosca.
  2. Drag and drop the relevant test cases onto the requirement they validate.
  3. Tosca automatically creates a reference link between the test case and the requirement.
  4. A link icon will appear under the requirement, confirming successful connection.
Requirements Test Case Execution

The linked structure forms the backbone of Requirements Test Case Execution, where each test result directly influences the requirement’s execution status.

Best Practices

  • Always ensure each requirement is linked to at least one test case.
  • Avoid redundant linking to prevent duplication in reports.
  • Periodically update linked items after major project changes.

Once this mapping is done, Tosca calculates requirement coverage and dynamically updates execution progress whenever tests are executed.

Linking Requirements with Execution Lists

Execution Lists in Tosca manage and track test case runs. By linking them to requirements, Tosca ensures execution outcomes reflect directly in requirement metrics.

Steps to Link Requirements with Execution List

  1. Create a new ExecutionList under the Execution section.
  2. Drag and drop your Test Cases or Test Case Folders into this list.
  3. Drag the entire Execution List and drop it into the appropriate RequirementSet.
Requirements Test Case Execution

Now, Tosca can automatically update the execution progress of each linked requirement whenever a test is run. This connection ensures complete transparency in Requirements Test Case Execution.

Project Status and Work State Logic

Each requirement’s Execution State (%) in Tosca is calculated based on the Work State of the test cases linked to it. This dynamic calculation helps you track project health at any given moment.

Work State Categories

  • Planned: Test cases are created but not yet executed.
  • In_Work: Test cases are currently being executed.
  • Completed: All linked test cases have finished execution.

As the work state of test cases changes, Tosca recalculates the Execution State (%) for each requirement. This ensures that the data shown in dashboards or reports truly reflects the project’s testing progress a key benefit of efficient Requirements Test Case Execution.

Manual Updating of Requirement Values

By default, Tosca requires manual updates of requirement values unless configured otherwise. Whenever changes are made to test cases or requirement links, Tosca highlights the affected RequirementSet with a blue exclamation mark.

Steps to Manually Update Requirement Values

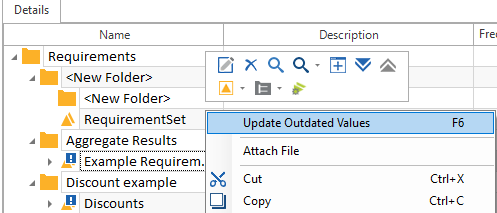

  1. Right-click the affected RequirementSet.
  2. Choose Update Outdated Values from the context menu.
  3. Tosca recalculates coverage, status, and execution percentages for all linked items.

Alternatively, to update all outdated values across your project:

  • Go to the dynamic menu Requirements and select Update Outdated Values globally.

This feature gives users precise control over when and how calculations are refreshed, which is especially valuable for performance optimization in large-scale Requirements Test Case Execution projects.

Automatic Updating of Requirement Values

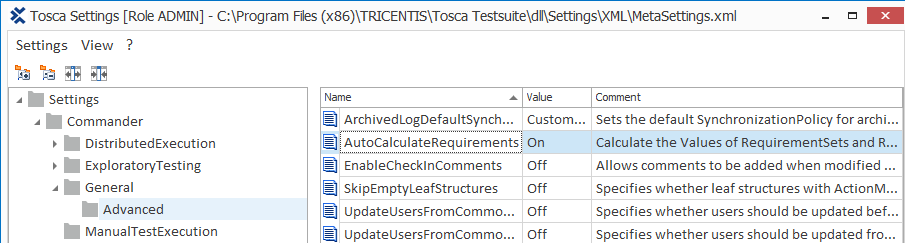

If you want Tosca to perform recalculations automatically, enable the AutoCalculateRequirements setting. This allows Tosca to synchronize and update all requirement metrics in real time.

Steps to Enable AutoCalculateRequirements

  1. Navigate to Project → Settings → Commander → General → Advanced.
  2. Locate AutoCalculateRequirements in the list.
  3. Change its value to On.
  4. Restart Tosca Commander for the setting to apply.

Once active, Tosca automatically recalculates whenever a change occurs such as test execution, work state update, or requirement modification. This automation ensures accurate, up-to-date Requirements Test Case Execution results.

Advantages of Automatic Updates

  • Removes the need for manual recalculations.
  • Keeps requirement data synchronized in real time.
  • Enhances collaboration among distributed teams.

Automatic synchronization also supports continuous integration pipelines, where test executions happen frequently and manual recalculation would be impractical.

Advanced Requirement Management Features

The Tricentis Tosca documentation highlights several advanced functionalities that enhance the Requirements Test Case Execution workflow.

Requirement Attributes

  • Name: Identifier for the requirement.
  • Description: Explains its purpose and expected outcome.
  • Weight: Defines priority or business impact.
  • Execution State (%): Displays test coverage progress.

Hierarchical Organization

Requirements can be nested under RequirementSets and folders to mirror business modules or release versions. This structure supports easier aggregation and reporting during Requirements Test Case Execution analysis.

Version Control and Collaboration

Tosca integrates with versioning systems like Git or SVN, allowing teams to manage requirement changes efficiently. When check-ins occur, updates automatically flow through the requirement hierarchy.

Using Aggregate Results and Execution Monitoring

The Aggregate Results section in Tosca consolidates outcomes from all linked execution lists. It calculates an overall success rate and coverage percentage per requirement.

This view becomes invaluable during Requirements Test Case Execution because it visually indicates which business requirements are fully validated and which need attention.

Key Metrics in Aggregate Results

  • Total Test Cases Linked
  • Number of Passed/Failed Tests
  • Execution Completion (%)
  • Requirement Fulfillment Status

These metrics help stakeholders assess product readiness and compliance with quality standards.

Real-World Scenario Example

Imagine a retail application project that includes modules such as “Login Functionality,” “Product Search,” and “Payment Processing.”

  1. You create three RequirementSets corresponding to these modules.
  2. Each RequirementSet contains individual requirements such as “User Authentication,” “Search by Category,” and “Credit Card Validation.”
  3. You link 10–15 test cases to each requirement.
  4. Execution Lists are created to group and run tests per module.
  5. After running the Execution Lists, Tosca automatically updates the Execution State (%) values of each requirement.

The dashboard now reflects:

  • Login module: 90% execution completed.
  • Product search: 100% passed.
  • Payment processing: 80% passed, 20% failed.

This is the practical visibility provided by Requirements Test Case Execution ensuring every business objective is verifiably tested.

Troubleshooting Common Issues

During daily operations, teams may face synchronization or linking errors. Below are common problems and their recommended solutions:

IssuePossible CauseResolution
Requirement values not refreshingAutoCalculateRequirements turned offEnable auto calculation or update manually
Blue exclamation mark persistsPartial recalculation failureRe-run “Update Outdated Values”
Missing test coverageUnlinked or deleted test caseRe-link test cases properly
Incorrect execution percentageIncomplete execution list linkageVerify Execution List association

Understanding these issues strengthens your control over the Requirements Test Case Execution lifecycle and improves reporting accuracy.

Integration with Reporting and Dashboards

Trcentis Tosca supports advanced reporting features that display requirement coverage, progress, and execution summaries.

With Requirements Test Case Execution, dashboards can be customized to show:

  • Requirement completion percentages.
  • Trend charts comparing planned vs. executed tests.
  • Pass/fail ratios per requirement group.
  • Historical data of requirement changes.

These reports are exportable in multiple formats for stakeholder review, ensuring complete project visibility from requirement definition to final validation.

Compliance and Audit Readiness

For regulated industries like finance, healthcare, and manufacturing, Tosca’s traceability model ensures compliance with audit standards such as ISO, FDA, and SOX.

Every link created during Requirements Test Case Execution serves as a verifiable audit trail from business requirement creation to execution results. This end-to-end traceability is a key factor in quality assurance audits and certification readiness.

Why Requirements Traceability Matters

The success of a testing project lies in visibility and accountability. The Requirements Test Case Execution process bridges the gap between what the business needs and what is validated by QA teams.

This traceability allows:

  • Business analysts to verify alignment with objectives.
  • Test leads to monitor execution completeness.
  • Managers to measure ROI of testing efforts.

Such alignment reduces project risk and increases confidence in release quality.

Key Takeaways

  • Tricentis Tosca’s requirement management system provides full traceability between business needs, test cases, and execution results.
  • Requirements are organized into folders and sets, linked to test cases, and connected with execution lists for real-time monitoring.
  • The AutoCalculateRequirements setting automates updates, while manual updates offer control for large projects.
  • Proper Requirements Test Case Execution ensures accurate coverage, efficient reporting, and continuous quality improvement.

By mastering these features through TOSCA Training, professionals can efficiently manage requirement-based testing workflows and prepare for advanced TOSCA Certification Process levels.

Conclusion

Mastering Requirements Test Case Execution in Tricentis Tosca is essential for achieving comprehensive traceability, real-time reporting, and quality assurance excellence. From creating structured requirement sets to linking them with test cases and execution lists, every step contributes to project transparency and precision.

Tosca’s flexible manual and automatic update mechanisms make it adaptable to both agile and enterprise testing environments. Implement these techniques in your next project and experience the power of accurate, traceable, and data-driven testing.

Share this article

Enroll Free demo class
Enroll IT Courses

Enroll Free demo class

Leave a Reply

Your email address will not be published. Required fields are marked *

This site uses Akismet to reduce spam. Learn how your comment data is processed.

Join Free Demo Class

Let's have a chat
